Across 130,324 projects tracked from 2017 to 2024, initiatives with a named owner were completed 2.5x as often. What the organizations that finish do differently.
- Give every project one active owner, never a committee or department. ClearPoint shows which assigned owners haven't updated their work in the last 90 days, so teams can follow up before the review.
- Reassign or cancel any project with no update in 90 days. Canceling now costs less than spending more resources on work that will not finish.
- Rebalance whenever one month holds more than 15% of planned completions. A December cluster makes teams delay work until Q4 and then scramble.
- Start only projects you can finish. Before a project enters the plan, check its strategic fit, owner and resources, as Germantown does.
- Use the five factors in the section on what the 5.7% do differently as your checklist. The 5.7% of organizations that average 93% completion share all five.
Across 130,324 projects tracked in ClearPoint from 2017 to 2024, ownership made the clearest difference to completion. Completion rates also varied by year, by industry and, most of all, by organization. A small group, 5.7% of organizations, averaged 93% completion. The useful question is what those organizations do differently.
What 2020–2023 revealed

When COVID hit in 2020, completion rates climbed instead of collapsing. The peak came in 2022 and 2023, when completion rates exceeded 20%, nearly double the 2017 baseline. During the crisis, meetings got shorter, decisions got faster, and departments dropped initiatives that did not matter, so the essential work got finished.
By 2024, most organizations had gone back to longer timelines, more meetings and slower decisions. Nothing about those crisis behaviors required a crisis, though. The organizations that kept their completion rates up treated shorter meetings, faster decisions and tight prioritization as standard practice rather than a temporary exception.

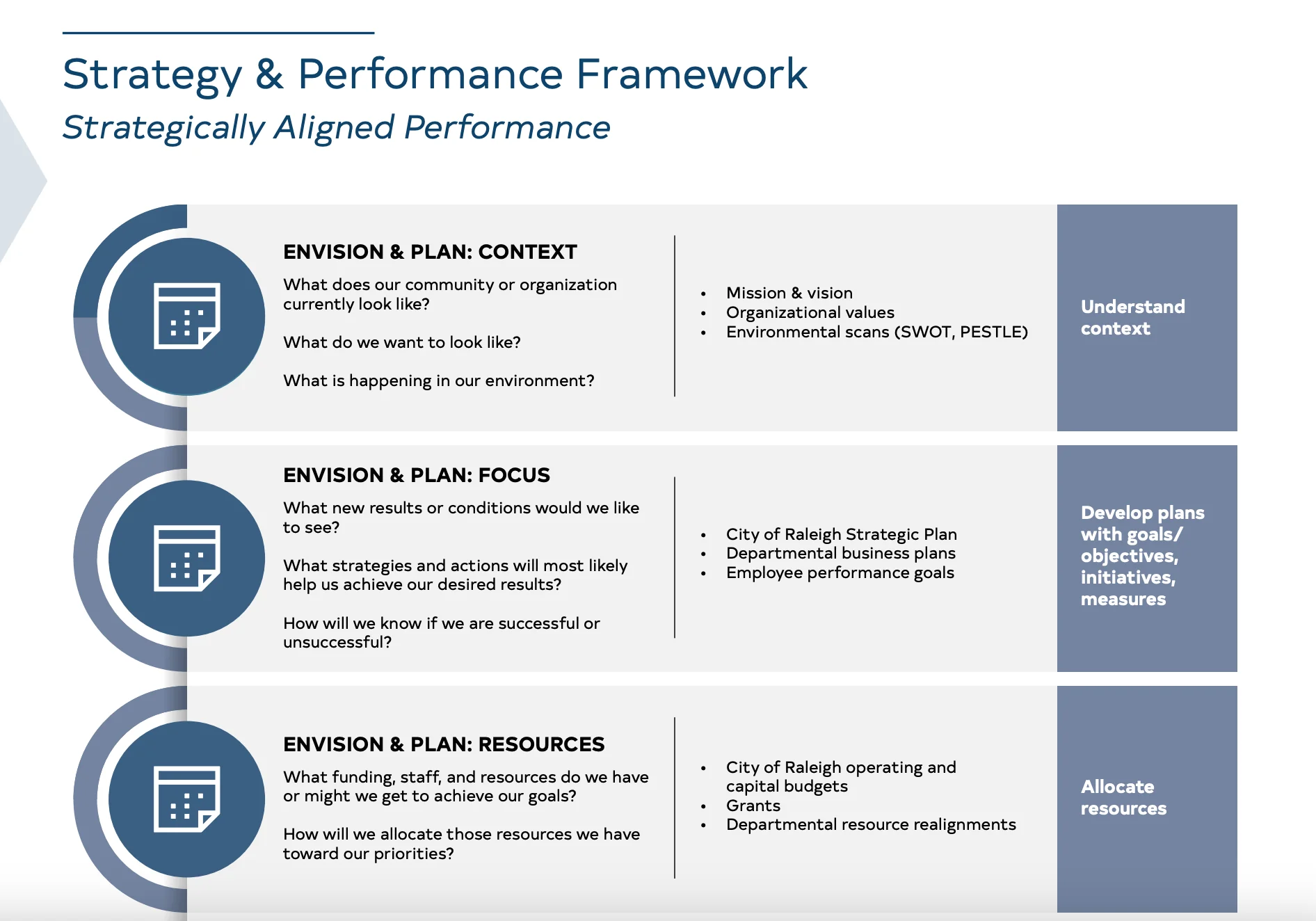

The City of Raleigh, North Carolina, had built its "Envision. Enact. Evaluate. Engage." framework before the pandemic. It ran CORStat (City of Raleigh Statistics) meetings, where cross-departmental teams discussed citywide measures and initiative progress and worked to remove blockers. Its Strategic Planning and Performance Analytics Academy had reached every city department, building the capacity to execute as well as plan.

Industry sets a baseline, not the outcome
Energy and utilities companies complete 25.81% of their strategic projects. Their work often involves regulated infrastructure with clear timelines and external accountability, such as a power substation or a water treatment upgrade, which is hard to let slide. Still, every sector in the data has organizations completing 90% or more of their projects alongside organizations completing less than 10%.
Local government is not usually considered a high-completion sector, yet Durham County, North Carolina, has built systems that get projects finished. Durham County and the City of Durham both use ClearPoint to share data and coordinate their work. That partnership produced six joint initiatives, all completed, including a CPR and defibrillator training program that has trained over 1,700 Durham Public Schools students. The same pattern shows up at JEA in utilities, Carilion in healthcare, and Fort Lauderdale and Germantown in local government.
The December problem
When a large share of a strategic portfolio is due in the same month, resources get stretched and projects that could succeed with focus get deprioritized because other projects share their deadline. When everything is due in December, teams delay work until Q4, then scramble to finish everything at once. Organizations with smoother completion calendars have higher overall completion rates.
Fort Collins, Colorado, moved from tracking 400+ metrics to a Strategy Map approach (Metrics, Analysis, Performance). It also replaced annual reviews built around year-end deadlines with quarterly strategic reviews focused on outcomes, so projects could finish when they were done rather than when the fiscal calendar said so. Raleigh did the same through quarterly evaluation in its CORStat meetings.
A practical rule: if any single month holds more than 15% of your planned completions, rebalance. Pull work forward and create mid-quarter finish windows.
The ownership gap

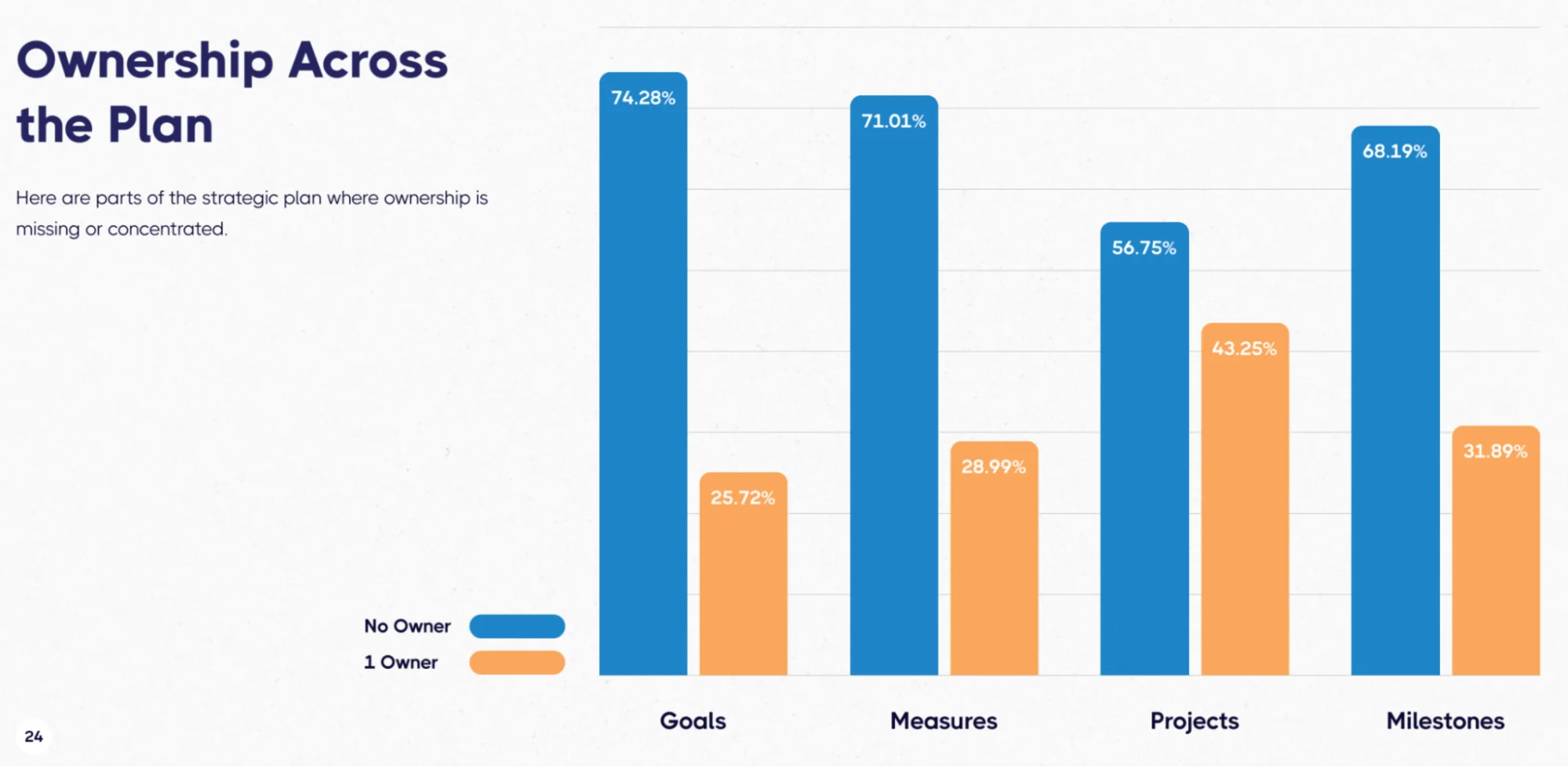

The biggest predictor of whether a project completes is whether it has an active owner, not the quality of the plan. ClearPoint customers can see which assigned owners haven't updated their work in the last 90 days, so they can follow up before a review. The charts below show how ownership is spread across a plan and how many owners are active.

Germantown, Tennessee, made ownership visible on its way to winning the Malcolm Baldrige National Quality Award. Every quarter, the City Administrator meets with each department director to review key metrics using "Business Plan" reports. Directors can view their strategic plan alignment at any time, and they know someone looks at it regularly.

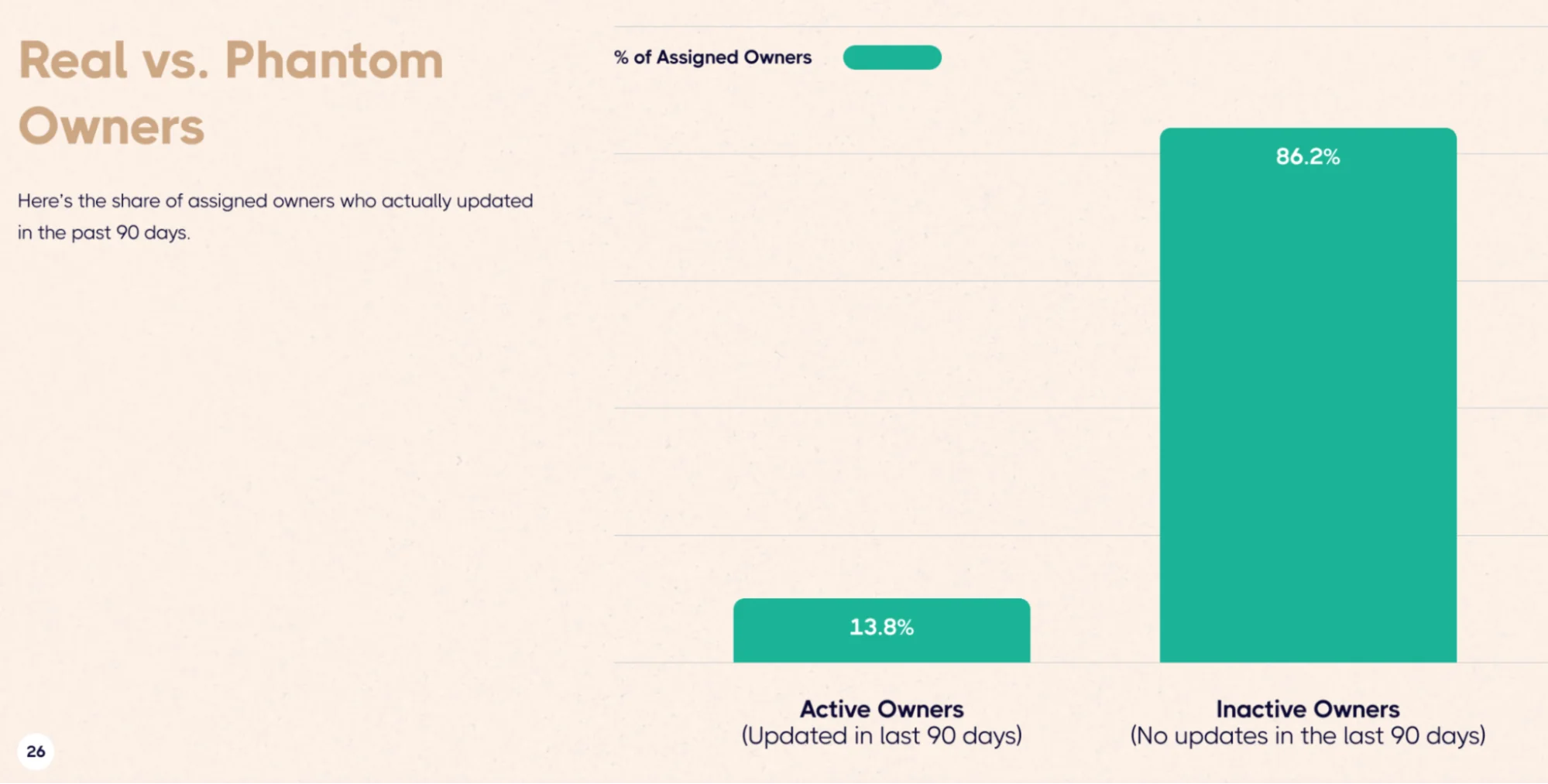

In Durham, because the city and county use the same ClearPoint system, ownership is visible across jurisdictional boundaries. Nobody can claim the other agency was supposed to do it. The fix is simple to state: every project gets one owner, not a committee or a department. If that person hasn't updated the project in 90 days, reassign it or cancel it. Canceling now costs less than spending more resources on work that will not finish.
What the 5.7% do differently

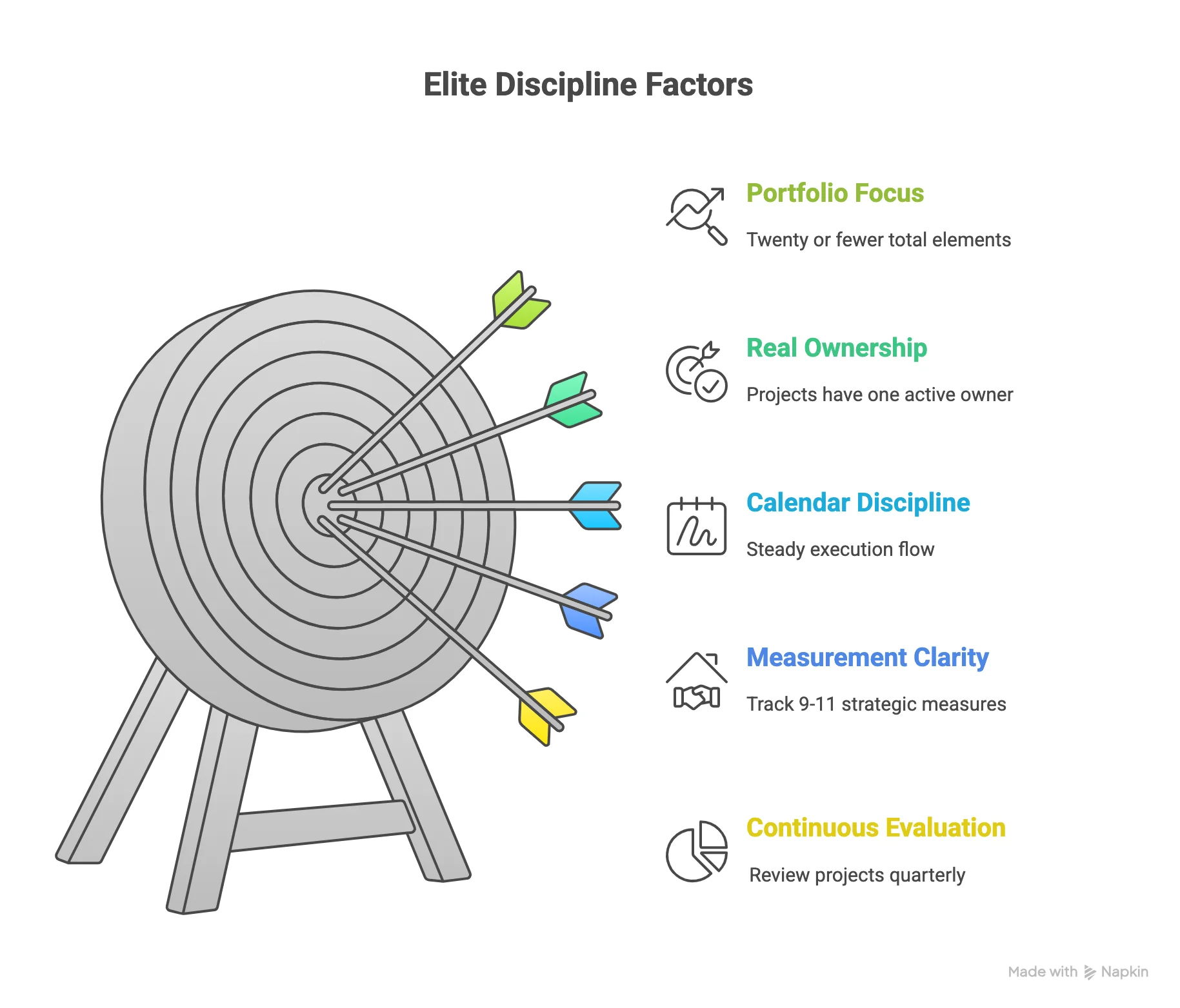

The organizations that average 93% completion share discipline around five factors:

- Portfolio focus: they keep 20 or fewer total elements (goals, measures, projects and milestones). Smaller portfolios succeed more often than plans with 60+ elements.
- Real ownership: every project has one active owner, they track the share of active owners as a metric, and they apply the 90-day rule.
- Calendar discipline: no single month holds more than 15% of completions.
- Measurement clarity: they track 9-11 strategic measures in total, about two per goal, and keep operational metrics separate.
- Continuous evaluation: they review progress quarterly or more often instead of waiting for an annual review.
Projects that never should have started
Many incomplete projects did not fail in execution. They should never have been strategic projects at all.

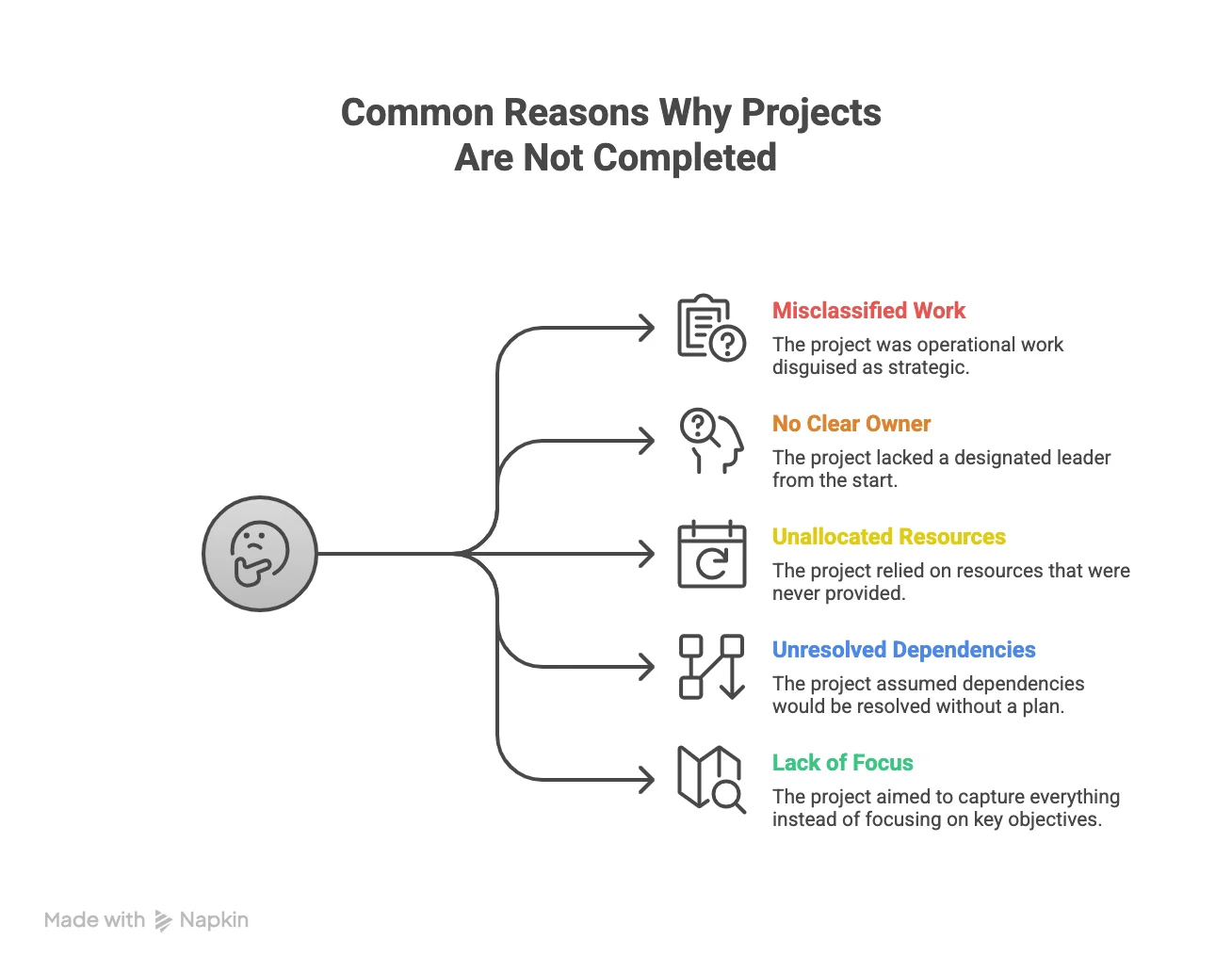

The common causes are operational work misclassified as strategic, no clear owner from day one, resources that were never allocated, dependencies with no plan to resolve them, and projects added to "capture everything." Fort Lauderdale launched "Press Play Fort Lauderdale" with 191 initiatives, many of them operational improvements or routine upgrades promoted to strategic status during planning. When the city narrowed to fewer, focused priorities, completion improved because it stopped starting projects with no realistic path to completion.
Germantown screens every project before it enters the strategic plan. It asks whether the project serves customer needs, whether it aligns with strategic objectives, and whether the city has the ownership and resources to complete it. A single no keeps it out, so the plan holds fewer projects than many comparable cities and each one has a realistic chance of finishing.
What incompletion costs
An incomplete project spends budget and staff time with no return, crowds out other work, and costs credibility when stakeholders see nothing finished. Durham County can point to results from completed initiatives: 1,700 students trained through its CPR program, $1.8 million in budget savings from eliminating non-strategic spending, and a consistent triple-A bond rating through economic challenges. Shari Metcalfe, Durham's Strategy and Performance Manager, describes the change:
"A big turning point for our performance management was getting a system that we could use to manage all that data. It's just easier. Less time putting numbers in a system and more time actually looking at the numbers and making decisions based on those."

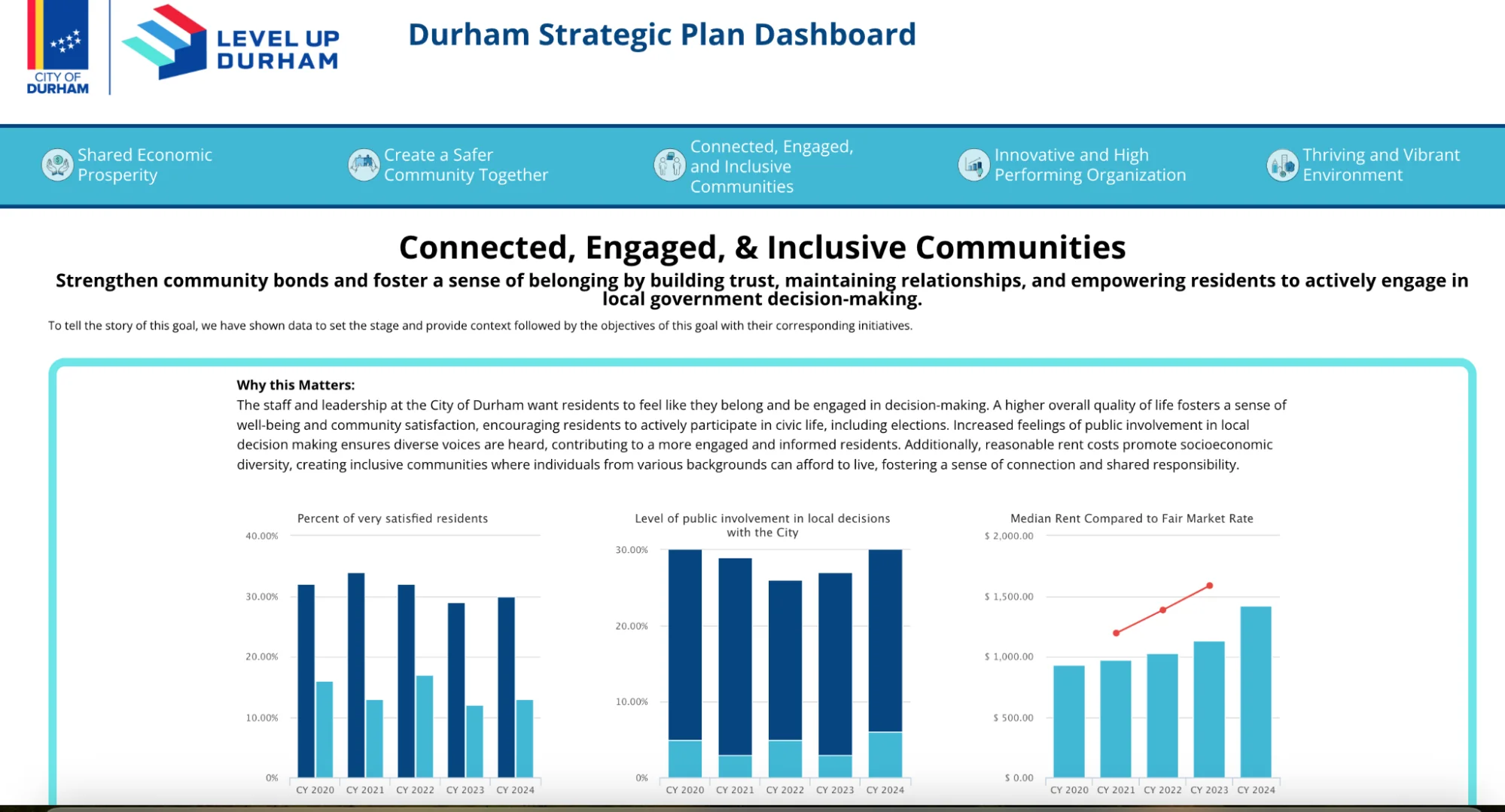

Visibility also drives completion. Durham's public dashboard shows residents what the city is working on, which creates internal accountability for finishing it. Germantown's community dashboard does the same: once you tell citizens what you will do, completing it stops being optional.

So how often are strategic initiatives completed?
Across the 130,324 projects, completion varies by year, industry and organization, and owned initiatives are completed 2.5x as often as unowned ones (21.5% vs. 8.7%). The top 5.7% of organizations reach 93%. The organizations in this article, from utilities and healthcare to local government, work under ordinary budget limits and stakeholder pressure. What they share is the five disciplines above: a focused portfolio, real owners, a spread-out calendar, a short list of measures, and frequent reviews.
