Most Gantt charts never finish. Owned initiatives finish 2.5x as often. Here's how to build one that survives, backed by data from over 20,000 strategic plans.
Key Takeaways
  • Split any project longer than two quarters into chunks with their own finish lines. Completion is 27.4% for 6-8 month projects vs 15.3% past nine months.
  • Make each owner's update take ten seconds. ClearPoint shows which named owners haven't logged an update yet, so teams can follow up before the review.
  • Map dependencies before you set dates. Showing which tasks block others is the reason a Gantt chart exists; a flat task list can't.
  • Link every project to an objective and a measure. Bars can all finish on time and still lose if they aim at the wrong goal.
  • Run the owner review in this guide's evaluation section every cycle. Each owner writes a short analysis, sets a RAG status and says what happens next.
Google AI answers

Get our answers first in Google.

Add ClearPoint as a preferred source →

The chart looked perfect. Forty-one bars, color-coded, every dependency drawn, every owner named. It was printed, framed, and pinned to the wall outside the project room. Nine months later, the same chart was still on the wall. And roughly a third of the bars had never moved.

We see this a lot. Not because people are lazy, but because a Gantt chart is easy to draw and hard to keep. It captures the plan on its best day, the day everyone agreed. Then Tuesday happens.

So before we show you how to build one, let's be honest about what the good ones have in common. We analyzed over 20,000 strategic plans on the ClearPoint platform, spanning 31.2 million rows of project data. What we found is the reason this guide is different from the other forty you'll find on this exact search.

The Gantt chart isn't the problem here. But a Gantt chart built without knowing this is just a prettier way to be surprised in Q4.

A Gantt chart is a project management tool that maps every activity in a project against a timeline. Named for the engineer Henry Gantt, who popularized it in the 1910s, it shows start and end dates, who owns what, what's done, and how a slip in one task pushes the tasks that depend on it. If you want the plain-English definition first, our team keeps a short explainer on what a Gantt chart is. This guide is about building one that survives contact with reality.

When you should (and shouldn't) reach for a Gantt chart

Use a Gantt chart when a project has real dependencies. Task B can't start until Task A ships. Task A takes two weeks minimum. Miss that, and the whole line moves. A Gantt chart makes that chain visible before it bites you.

But here's the part most guides skip. Sometimes we tell clients not to build one. If your work is a steady stream of independent tasks with no dependencies, a project dashboard or a Kanban board will serve you better. And if your initiative runs longer than a year, a Gantt chart can actively hurt you. We'll come back to why, because the data on that is blunt.

How to create a Gantt chart in 8 steps

The mechanics are simple. That's never been the hard part. We'll give you the eight steps, and at the two steps that decide whether plans finish, we'll show you what the data says.

1. Name the project. One initiative, one clear finish line. 'Improve resident services' is not a project. 'Launch the online permit portal by March 31' is.

2. List every step, start to finish. Map the work from kickoff to rollout. Miss a step now and your timeline lies to you later.

3. Find the dependencies. Mark what runs in parallel and what has to run in sequence. This is the entire reason a Gantt chart exists. A flat task list can't show you that the vendor contract blocks six other things.

4. Set the timeframes. Use software to lay the bars against the calendar. Do this by hand once, to feel the pain. Then never do it by hand again.

5. Add the context. Budget, description, and the 'why' behind each bar. A bar with no context is a task nobody will defend when it slips.

6. Break down the budget. Tie spend to milestones. A Gantt chart that shows time but not money only tells you half the story.

7. Assign an owner to every bar. This is the step that decides whether the chart lives or dies.

The owner column decides completion

What a named owner is worth

2.5xcompletion with a named owner

Initiatives with a named owner are completed 2.5x as often as those without one (21.5% vs. 8.7%). ClearPoint shows which owners haven't updated their items yet, so teams can follow up before the chart goes stale.

A name in the owner column is not accountability. It's a hope with a face on it.

Source: ClearPoint platform · 200+ organizations · 2026.

Assigning an owner is easy. Getting that owner to keep their bar honest is the whole game. 'Every task should have an owner' is advice you've read a hundred times. Nobody tells you that the chart only stays honest if the owner keeps updating. Design your chart so an update costs ten seconds, not ten minutes, or the owner column becomes fiction by week three.

8. Keep it in front of people. A Gantt chart is a living reference, not a launch artifact. The moment it lives in a folder instead of a meeting, it's dead. For the discipline of running it week to week, we wrote a longer piece on strategic project management.

The two kinds of Gantt charts you'll actually build

There are two, and confusing them is a common mistake.

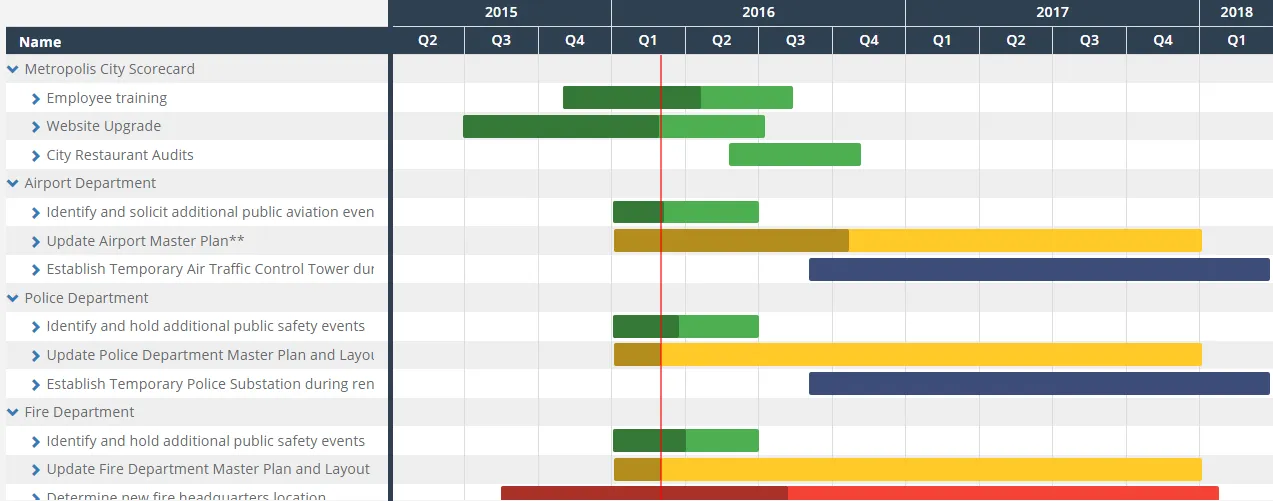

The high-level, organizational Gantt chart. Every project across the org, with names and status. This is the C-suite view — the one that answers 'are we overloaded, and where do we move resources?' A typical mid-size city on our platform is tracking a median of 136 active projects across 18 plans. No one holds that in their head. The City of Bartlett, Tennessee, runs its entire Vision 2030 plan this way — dozens of projects, one board leadership can actually read. This chart is how leadership sees the whole board at once.

The project-specific Gantt chart. One initiative, exploded into milestones, sub-milestones, and the dependencies between them. This is the working view for the team actually doing the work. Timelines and budgets get adjusted here, in the trenches.

Most teams need both. The org chart tells you what is happening. The project chart tells you whether it's happening on time.

When a Gantt chart hurts you: the length trap

Now the part we promised. A Gantt chart is a bet on your ability to predict the future. The longer the bar, the worse the bet.

The length cliff

Share of projects that reach completion, by planned length

6–8 months27.4%
9–11 months15.3%

Completion rate peaks in the 6–8 month window and nearly halves once a project stretches past nine months. Source: ClearPoint 2026 Strategic Planning Report · over 20,000 plans analyzed (2017–2024).

Completion peaks in the 6–8 month window at 27.4%. Push a project past nine months and it drops to 15.3%. Multi-year initiatives fall off a cliff. So if you're about to draw an 18-month bar, don't. Break it into two-quarter chunks with their own finish lines, or the Gantt chart becomes a monument to a plan nobody remembers making.

There's a second trap: the calendar. On our platform, 27% of projects start in January and 28% are dated to end in December. That's not planning. That's the fiscal calendar drawing your chart for you. Real work rarely respects January 1st. When every bar snaps to the calendar's edges, you're looking at a wish, not a schedule.

What Balanced Scorecard practitioners get wrong about Gantt charts

ClearPoint was built by people who spent years inside the Balanced Scorecard world, where the first question is never 'are we busy?' It's 'are we winning?' That lens changes how you read a Gantt chart.

Here's the trap even seasoned strategy people fall into. They treat the Gantt chart as the plan. It isn't. A Gantt chart tracks tasks. Strategy is about outcomes. You can finish every bar on time and still lose, if the bars were pointed at the wrong hill.

The fix is to connect the schedule to the scorecard. Every project on your Gantt chart should ladder up to an objective it's meant to move, and a measure that proves it moved. That link is exactly what a project and portfolio management system does that a standalone Gantt tool can't. The bar tells you the work happened. The measure tells you the work mattered. You need both, and most tools only give you the first.

How to evaluate your Gantt chart, cycle after cycle

A Gantt chart earns its keep at the review, not at the launch. At the end of each reporting cycle, every owner should do three things.

Write a short analysis. Set a RAG status — red, amber, or green — that a busy executive can read in a glance. And say what happens next. Not '70% complete.' Instead: 'amber, the vendor slipped two weeks, here's how we hold the launch date.' Status without a recommendation is just a color.

Judge the chart on four things: milestone status, percent complete, schedule variance (ahead, behind, on time), and budget. Skip the exhaustive line-by-line. Executives don't need every task. They need to know what's at risk and what you're doing about it.

What to look for in Gantt chart software

You can start in a spreadsheet. Grab our free Gantt chart Excel template and you'll have a working chart in an afternoon. For a single, simple project, that's enough.

Past that, three features separate software that helps from software that nags.

Status that updates itself. Colors and percent-complete should move as the work moves, not because someone remembered to recolor a cell. If updating is friction, updating won't happen.

Visual hierarchy. Indentation, color, and grouping that let you tell a parent milestone from its sub-tasks at a glance.

Live dependencies. Arrows between linked tasks, and automatic date-shifting when a predecessor slips. This is the single feature that turns a Gantt chart from a drawing into a warning system. When Task A moves, every downstream bar should move with it, without you touching a thing.

For the wider category — how projects, dashboards, and reporting fit together — start with our overview of project management.

A Gantt chart is not a picture of your project. It's a promise your team makes about the future — drawn in bars, dated to the day. The drawing is the easy part. Keeping the promise, week after Tuesday after week, is the work. Build the chart so keeping it is the path of least resistance. That's the whole difference between a chart that gets finished and one that stays on the wall.

See your projects and strategy on one screen — book a demo

Common questions

How do I create a Gantt chart from scratch?

List every task in your project, mark which tasks depend on others, set start and end dates for each, then lay the bars against a calendar. Assign one owner per task and add budget context. Software does the layout and the math; you supply the plan.

What happens when a task slips?

Every task that depends on the slipped one moves too. Good Gantt software cascades those date changes automatically. If you're working by hand, update the dependent bars yourself, and communicate the new finish date to everyone downstream the same day.

When should I not use a Gantt chart?

Skip it when your work is a stream of independent tasks with no dependencies — a Kanban board fits better. And be careful with initiatives longer than a year. In our data, project completion nearly halves once a project stretches past nine months, so long bars are a warning sign, not a plan.

How many milestones should a Gantt chart have?

Fewer than you think. Leanness predicts completion better than any framework. Break anything longer than two quarters into chunks with their own finish lines. A chart no one can read in thirty seconds is a chart no one will maintain.

Where does ClearPoint's Gantt chart data come from?

From the 2026 Strategic Planning Report, an analysis of over 20,000 strategic plans and 31.2 million rows of project data on the ClearPoint platform (2017–2024), plus current platform metrics across 150+ organizations. It's the same data our customers use to run their plans.

What's the difference between a Gantt chart and a project dashboard?

A Gantt chart shows time — what happens when, and in what order. A project dashboard shows health — status, budget, and progress across many projects at once. Most teams running real portfolios use both.
